State Estimates Delta Tunnel’s Cost at $15.9 Billion, but Critics Point to Higher Cost

by Dan Bacher
“That Gavin Newsom and California Natural Resources Secretary Wade Crowfoot are working with Trump to push this through during a pandemic, while many of the people that will be impacted can’t engage, shows disrespect for Native Americans and other rural and salmon dependent communities,” said Regina Chichizola, co-director of Save California Salmon.
As hundreds of wildfires raged throughout California, a report released at the Delta Conveyance Design and Construction Authority (DCA) on-line meeting on August 20 revealed that the cost estimate for Gavin Newsom’s Delta Tunnel is up to $15.9 billion.

The estimate is based on a single tunnel with a total capacity of 6,000 cfs. with two intakes of 3,000 cfs. The project would feature 42 miles of tunnels and associated shafts, Southern Complex Facilities with a Pump Station and Forebay, and connections to the existing California Aqueduct of the State Water Project (SWP).

The tunnel is opposed by a large coalition of recreational and commercial fishermen, Tribal leaders, scientists, subsistence fishermen, family farmers, Delta business owners, boaters, environmental justice advocates, Southern California water ratepayers, elected officials and the people of California.

If built, critics say the actual tunnel costs would undoubtedly exceed the original estimates at the same time that the project hastens the extinction of winter and spring run Chinook salmon, Central Valley steelhead, Delta and longfin smelt and other state and federal listed fish species. The enormously expensive project would also imperil the salmon and steelhead populations on the Trinity and Klamath rivers that the Yurok, Karuk and Hoopa Valley tribes have been fishing for since time immemorial.

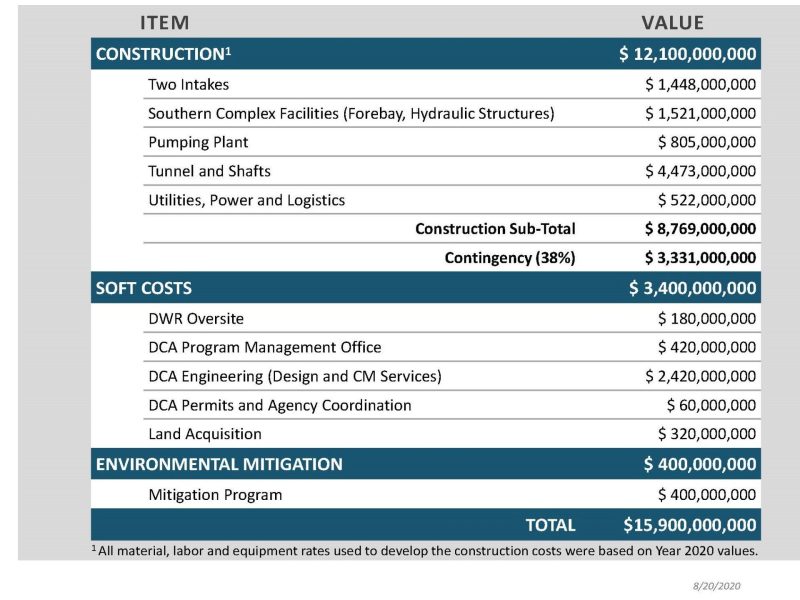

The construction costs would total $12,100,000,000. This would include $1,448,000,000 for the the two intakes, $1,521,000,00 for the Southern Complex Facility (Forebay Hydraulic Structures), $805,000,000 for a Pumping Plant, $4,473,000,000 for the Tunnel and Shafts and $522,000,000 for Utilities, Powers and Logistics. The Construction Subtotal would be $8,769,000,000 with a 38% contingency of $3,332,000,000.

In case you’re wondering, that 38% “contingency” is “part of the construction cost,” according to the report. “It represents a best guess of the unknown items where experience indicates, will likely result in additional cost.”

That’s reassuring, isn’t it!

The “Soft Costs” would total $3,400,000,000, including $180,000,000 for DWR Oversite, $420,000,000 for the DCA Program Management Office, $2,420,000,000 for DCA Engineering (Design and Contract Management Services), $60,000,000 for DCA Permits and Agency Coordination and $320,000,000 for Land Acquisition.

The cost for “Environmental Mitigation” of the environmentally destructive public works project would be $400,000,000.

In a thread of tweets, Barbara Barrigan-Parrilla, Executive Director of Restore the Delta, responded to the updated cost estimate by the DCA, pointing out that the actual cost of the project would likely to be much higher than the new estimate.

“The single tunnel is now up to $15.9 billion. There is a 10% chance according to the @dcdcainfo’s director the project could go up to $25 billion. She worries we will take it out of context,” wrote Barrigan-Parrilla.

“We don’t have to take costs out of context,” she explained. “The average California project comes in at 6 times projected costs. But figuring they have a smart team, and there are no overruns, there is 5% annual inflation, which gets the project to over $25 billion.”

She also criticized the low cost estimate for the mitigation for the environmentally destructive public works project.

“Last, and worst, there is only $400 million for Delta tunnel mitigation,” she wrote. “That cannot repair habitat, lost farmland, lost business, or Stockton’s drinking water system. It will not mitigate harmful algae blooms (HABs). It will not mitigate air pollution impacts.”

She concluded, “It will not mitigate the damage done to environmental justice communities up and down the state, and in the Delta, not served by the State Water Project. $400 million will not provide mitigation to EJ communities rural and urban in the Delta.”

Tim Stroshane, also with Restore the Delta, quipped about the “tunnel vision” of the Delta Tunnel: “It’s nearly as expensive as the two tunnel version canceled last year. One for the price of two—what a deal!”

Regina Chichizola, co-director of Save California Salmon, criticized the Newsom Administration for continuing to go forward with the Delta Tunnel in the midst of the global coronavirus pandemic.

“That Gavin Newsom and California Natural Resources Secretary Wade Crowfoot are working with Trump to push this through during a pandemic, while many of the people that will be impacted can’t engage, shows disrespect for Native Americans and other rural and salmon dependent communities,” emphasized Chichizola.

The Delta Tunnel is a key part of Newsom’s larger “water vision” for California. On July 28, Newsom unveiled a final version of his controversial Water Resilience Portfolio, a water plan that that includes the Delta Tunnel, Sites Reservoir and the agribusiness-promoted “voluntary agreements,” all designed to benefit San Joaquin Valley corporate agribusiness interests.

“Governor Newsom is continuing to sell out our rivers and salmon to benefit water brokers and large agricultural corporations,” said Chichizola. “These are the same corporations that are polluting our rivers and drinking water, then exporting their products.”

Newsom received a total of $755,198 in donations from agribusiness in the 2018 election cycie, based on data from http://www.followthemoney.org. That figure includes $116,800 from Beverly Hills agribusiness tycoons Stewart and Lynda Resnick, the largest orchard fruit growers in the world and the sponsors of the Coalition for a Sustainable Delta, a corporate agribusiness Astroturf group.

By fast-tracking the Delta Tunnel plan, promoting the voluntary water agreements, overseeing the issuing of a new draft EIR that increases water exports for the state and federal projects rather than reducing them, and backing Sites Reservoir, could Newsom be bending to the wishes of his agribusiness donors?
